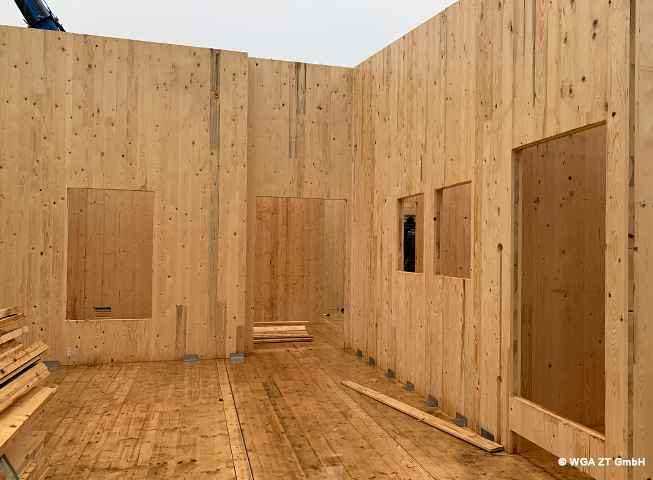

The team of dedicated employees is working hard to make as much progress as possible on the extension to the kindergarten before the end of the year. Our goal is to have the building watertight by calendar week 52. The daily efforts are also quite noticeable: the scaffolding on the ground floor is already in place and the timber construction walls are almost completely in place and are connecting directly to the existing kindergarten. In calendar week 51, the wooden ceilings for the flat roof areas and the pitched roofs will be delivered and installed so that the sealing work can also be completed before the Christmas holiday break. The window openings will be covered with canvasses, because the windows will not actually be delivered until the new year. We look forward to reporting more progress in the upcoming year.
